How Long Does a Bathroom Remodel Take in St. Petersburg? (2026 Timeline)


A bathroom remodel in St. Petersburg takes anywhere from 1 week to 12+ weeks of active construction, depending on scope. A cosmetic refresh runs 1–2 weeks. A mid-scope gut with a tub-to-shower conversion takes 3–4 weeks. Full structural work with moved walls and relocated plumbing lands at 5–8 weeks. Primary suites and custom builds run 8–12+ weeks. Add 3–5 weeks of pre-construction and 3–5 weeks for Pinellas County permit review before any of that starts. Total calendar time from first meeting to final walkthrough: 2 to 6 months.
Those are real numbers from a contractor who builds these every month — not national averages pulled from a content farm. Below, we break down the timeline by scope, walk through a typical 4-week schedule, and cover the St. Pete–specific factors (cast iron drains, condo elevators, historic districts, coastal flood zones) that most generic guides ignore entirely.
For the return-on-investment side of this conversation, see our bathroom remodel ROI in Florida guide. For help deciding whether you need a full remodel or a refresh, see bathroom remodel vs. refresh. For the full service, visit our bathroom remodel services page.
Bathroom Remodel Timeline by Scope
Scope drives everything. The same 5x7 bathroom can take a week or three months depending on what you’re doing to it.
| Project Scope | Active Construction | Total Timeline (Design to Finish) | What’s Included |
|---|---|---|---|
| Cosmetic Refresh | 1–2 weeks | 4–8 weeks | New paint, vanity swap, fixture swap, mirror, accessories. No plumbing or electrical changes. |
| Mid-Scope Gut | 3–4 weeks | 10–16 weeks | Tub-to-shower conversion, new tile floor-to-ceiling, new vanity, new fixtures. Same footprint. |
| Full Structural | 5–8 weeks | 16–22 weeks | Move walls, relocate plumbing, change layout, cut concrete slab for new drain locations. |
| Primary Suite / Custom | 8–12+ weeks | 20–30+ weeks | Full custom design, steam shower, heated floors, body jets, custom millwork, freestanding tub. |
Active construction is hammer-to-nails time on the jobsite. Total timeline includes design, selections, pre-construction budgeting, permit review, and material lead times — all the work that happens before demolition day.
Cosmetic refresh (1–2 weeks)
A refresh keeps the plumbing and electrical exactly where they are. You’re swapping surfaces and fixtures — not changing the bones. Our carpenters can usually knock out a refresh in 5–10 working days.
No permit is required for this scope. No inspections. The longest item is usually paint dry time and waiting for your new vanity to arrive from the vendor.
Mid-scope gut (3–4 weeks)
This is the most common bathroom remodel in St. Pete. You’re gutting the room down to studs and subfloor, but the drain locations stay put. The tub becomes a tiled shower. The vanity gets wider. The fixtures get upgraded. The tile runs floor-to-ceiling.
Active construction is 3–4 weeks if the crew can work continuously. Pinellas County permits are required for the plumbing and electrical rough-in, and mid-construction inspections (rough plumbing, rough electrical, shower pan, final) are built into the schedule.
Full structural (5–8 weeks)
Once walls move or plumbing relocates, you’re in full structural territory. Cutting a concrete slab to recess a new drain line adds days. Moving a load-bearing wall requires a structural engineer stamp. Expanding a bathroom into a closet means new framing, new electrical runs, and often HVAC rework.
Most St. Pete homes built before 1975 sit on concrete slabs. Every drain relocation means slab cutting, new DWV (drain-waste-vent) rough-in, and a slab patch — typically 3–5 extra days per drain moved.
Primary suite or custom work (8–12+ weeks)
A primary suite bathroom with a steam shower, heated tile floor, custom vanity, freestanding tub, frameless glass enclosure, and premium tile work takes real time. Not because the work is mysterious — because there’s a lot of it, and it has to happen in sequence.
Custom glass enclosures alone add 4–6 weeks of lead time from the day the shower is tiled and measured. Custom vanities from a local cabinet shop run 6–10 weeks. Imported tile can take 8–12 weeks. These lead times are the real timeline drivers, not labor speed.
Week-by-Week Schedule: A Typical 4-Week Mid-Scope Gut

Here’s what a 4-week bathroom gut actually looks like on a St. Pete jobsite. Schluter Kerdi waterproofing, a tub-to-shower conversion, new vanity, new tile, same footprint. Our 20+ W-2 carpenters handle demo, framing, waterproofing, tile, and finish carpentry in-house. Plumbing and electrical are coordinated with long-standing subs who show up when we call.

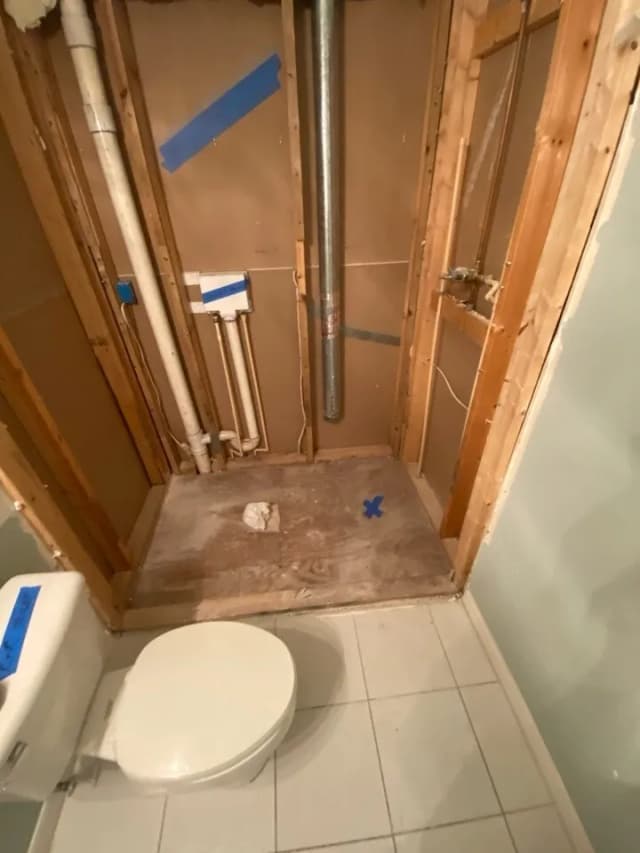

Week 1 — Demolition and rough-in
- Day 1: Protect the home (floor protection from the front door to the bathroom, dust containment zip walls, negative air if needed).
- Days 1–2: Demo to studs and subfloor. Haul-off and disposal.
- Day 2–3: Framing adjustments (new shower opening, blocking for grab bars or niches).
- Days 3–5: Plumbing rough-in. New shower valve, drain modifications, water supply lines. Electrical rough-in for new lighting, exhaust fan, GFCI outlets.
- End of week: Rough inspection scheduled with St. Petersburg Building Department.
Week 2 — Waterproofing and prep
- Days 1–2: Rough plumbing and electrical inspections. Inspectors from the City of St. Petersburg visit the jobsite.
- Days 2–3: Cement board or Schluter Kerdi board installation on walls. Backer prep for floor tile.

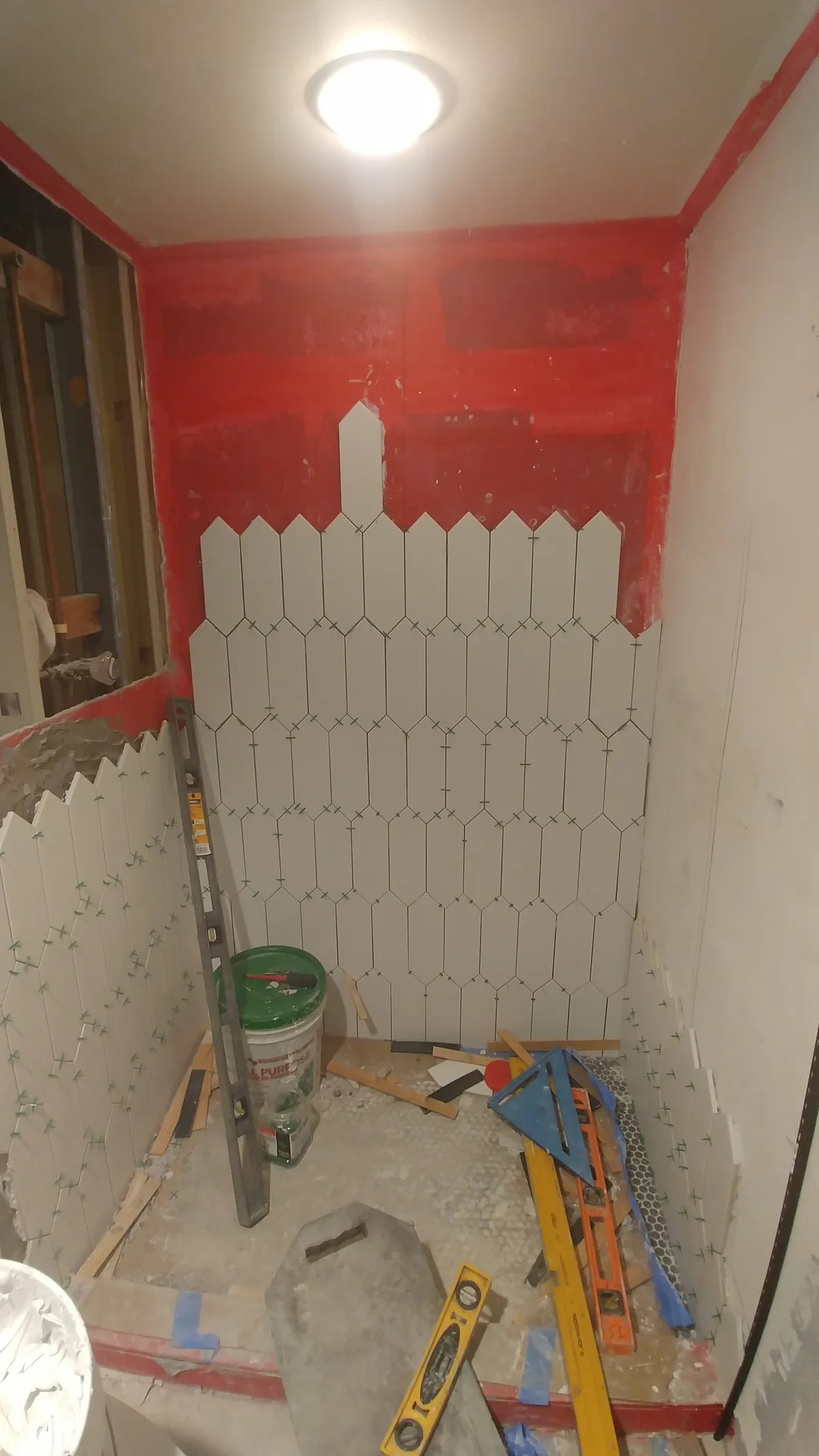

- Days 3–5: Schluter Kerdi waterproof membrane installed — walls, floor, pan, niches. Schluter Kerdi-Drain set. Shower pan inspection scheduled.
- End of week: Pan flood test. Twenty-four hours with water standing in the shower pan to verify the waterproofing holds.
Week 3 — Tile and glass measure

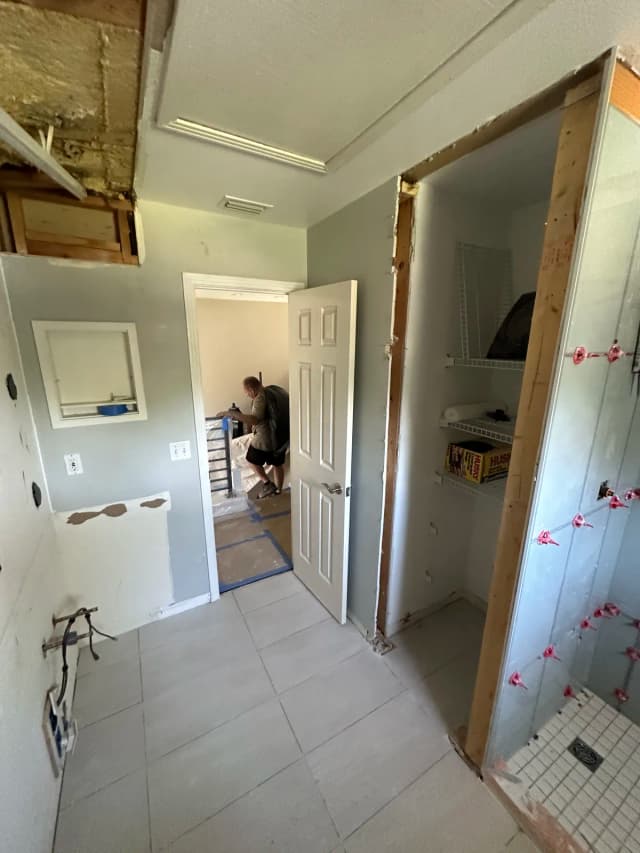

- Days 1–3: Floor tile installation.
- Days 3–5: Wall tile installation — shower walls first, then wet walls, then any accent walls. Tile niches set.
- End of week: Grout. Glass shower door templater comes out to measure for the custom enclosure. Glass lead time starts (typically 2–4 weeks from measure to install).
Week 4 — Finish carpentry and punch list
- Days 1–2: Vanity set, countertop install, sink and faucet plumbing trim-out.
- Days 2–3: Toilet set, towel bars, accessories, mirror, final paint touch-ups.
- Day 3: Final plumbing and electrical trim — light fixtures, exhaust fan grille, shower trim, outlets, switches.
- Days 4–5: Final inspection with City of St. Petersburg. Punch list walkthrough with the homeowner.
- Glass door installs 2–4 weeks later once it’s fabricated.
That’s the standard rhythm. Real projects vary — especially when week 1 demo reveals something nobody expected.
Ready to start your bathroom remodel?
Call Revolution at (727) 888-6161 or request a free 48-hour estimate.
What Actually Causes Bathroom Remodel Delays
Timelines don’t slip because crews are slow. They slip because of five things, in roughly this order:
1. Permit review at Pinellas County
St. Petersburg Building Department plan review runs 3–5 weeks on residential bathroom remodels in 2026 — longer if the reviewer flags something and a resubmittal is required. Permits cover plumbing, electrical, and any structural work. A cosmetic refresh (no plumbing, no electrical) doesn’t need one.
2. Inspection re-dos
Every permitted bathroom has at least four inspections: rough plumbing, rough electrical, shower pan, and final. If one fails — say the inspector flags a missing nail plate on a stud where a pipe runs, or a GFCI wired to the wrong circuit — it can push the schedule 2–5 days while the fix and re-inspection are scheduled.
3. Tile lead times
Common ceramic and porcelain tile is usually in stock locally. Specialty tile — imported, handmade, large-format, or mosaic — can take 6–12 weeks. Tile selected after demo day is tile that stalls your project. The fix: lock tile selections during design and pre-construction, before any hammers swing.
4. Glass shower door lead times
Frameless glass enclosures are custom — they get measured once the shower is tiled, then fabricated at a local glass shop. Standard turnaround is 2–4 weeks from measure to install. For anything unusual (oversized panels, steam shower glass, specialty hardware), plan on 4–8 weeks.
5. Hidden conditions behind the walls
This is the big one in older St. Pete homes. Cast iron drain stacks that have corroded closed. Unpermitted DIY plumbing from the 1970s. Knob-and-tube wiring no one knew was there. Rot behind a tub that hasn’t been touched since 1952. These discoveries happen on demo day, and they add real time.
A camera scope of the drain stack before demo ($100–$300 from a plumber) catches most cast iron surprises early. Read more about hidden cost drivers in our bathroom remodel cost guide.
St. Pete–Specific Timeline Factors
Three things affect bathroom remodel timelines in St. Pete that you won’t find in a national article.
Condo remodels: elevator scheduling and HOA review
Downtown St. Pete condo bathroom remodels add time most homeowners don’t plan for. Most high-rise buildings require:
- HOA architectural review before permits can even be pulled (2–6 weeks).
- Elevator reservations for material delivery and debris removal — usually limited to specific days and hours.
- Certificate of Insurance on file with the building before work starts.
- Restricted working hours (often 8am–5pm weekdays only, no weekends).
A bathroom remodel that takes 4 weeks in a single-family home can take 6–8 weeks in a downtown condo — not because the work is harder, but because the logistics eat days. See our condo remodel HOA and elevator guide for the full playbook.
Historic districts: Certificate of Appropriateness
Old Northeast, Historic Kenwood, Historic Uptown, and Roser Park all sit inside St. Pete historic districts. Bathroom interiors are usually fine without Historic Preservation Commission review — but any exterior-visible changes (a new bathroom window, a vent penetration through a street-facing wall, a new exterior door) can trigger a Certificate of Appropriateness (COA) review.
COA review adds 4–8 weeks to the front end of a project. Most interior-only bathroom remodels skip this entirely. Revolution has done the dance with the preservation board on enough projects to know when a COA is required and when it isn’t.
Coastal flood zones: substantial improvement rules and material lead times
Parts of Shore Acres, Snell Isle, Venetian Isles, Bahama Shores, and Tierra Verde sit in FEMA AE and VE flood zones. If your total renovation over any rolling 12-month window exceeds 50% of the home’s market value, FEMA’s substantial improvement rule kicks in. A bathroom alone rarely triggers it — but combined with a kitchen or addition, it can.
Triggering substantial improvement means the entire lowest floor has to be brought up to the current Base Flood Elevation (BFE). That’s a different project entirely — and a timeline question worth asking before work starts. For the full picture, see our Pinellas County flood zone guide.
Coastal homes also have longer material lead times for certain items. Impact-rated exhaust fan vents, hurricane-rated exterior penetrations, and marine-grade hardware can all take 2–4 weeks longer than standard.
How Revolution Keeps Bathroom Remodels on Schedule

Most contractors blame delays on subs, weather, inspectors, or the supply chain. Those delays are real — but they’re also usually manageable if the contractor plans for them.
Here’s how our process keeps bathroom projects on pace:
20+ W-2 carpenters on payroll. Our crew works for us, not for whoever’s paying most that week. When one job wraps, the next one starts — we’re not waiting for a sub to finish someone else’s project. That alone eliminates the single biggest source of timeline slip in the industry.
Dedicated superintendent on every project. One superintendent runs your bathroom from day one. Same person, same phone number, same accountability. They know what was ordered, what’s inspected, what’s next, and what’s at risk.
Pre-construction that’s actually done. By the time we swing a hammer, tile is ordered, fixtures are confirmed, plumbing and electrical subs have their start dates, and 90–95% of the budget is locked in. No “we’ll figure out the tile later.” Later is how projects stall.
Open-book T&M pricing with weekly budget reports. Time & Materials (T&M) means you pay for actual labor and actual materials with a stated markup — not a padded fixed bid. Every week you see where the money went and where the schedule stands. No surprises at the end.
Free 48-hour estimates. When you call, we come out, walk the space, and get you a realistic range and timeline within 48 hours. No pressure, no upsell.
Frequently Asked Questions
How long does a bathroom remodel take from start to finish?
Total calendar time from first meeting to final walkthrough runs 2–6 months. A cosmetic refresh can finish in 4–8 weeks. A mid-scope gut runs 10–16 weeks (including 3–5 weeks pre-construction, 3–5 weeks permit review, and 3–4 weeks construction). Full structural or primary-suite work runs 16–30+ weeks. Active construction is only a fraction of that total — most of the calendar is design, selections, permitting, and material lead times.
How long does a bathroom remodel take once construction starts?
Active construction ranges from 1 week for a refresh to 12+ weeks for a custom primary suite. The most common bathroom remodel in St. Pete — a mid-scope gut with a tub-to-shower conversion, new tile, and a new vanity in the existing footprint — takes 3–4 weeks of continuous work with an in-house crew.
How long does a Pinellas County bathroom remodel permit take?
Permit plan review at the St. Petersburg Building Department runs 3–5 weeks in 2026 for residential bathroom remodels. Cosmetic refreshes (no plumbing or electrical changes) don't require a permit. Condo remodels add HOA architectural review on the front end, which can add another 2–6 weeks before permit submittal even begins.
How long does a tub-to-shower conversion take?
A tub-to-shower conversion in the existing footprint takes about 3 weeks of active construction: 3–5 days demo and rough-in, 3–5 days waterproofing and pan test, 5–7 days tile, and 2–3 days finish carpentry and glass measure. Custom glass enclosures install 2–4 weeks later once fabricated. If the drain has to relocate, add 2–3 days of slab-cutting work.
Why do bathroom remodels take so long?
Five reasons: permit review at Pinellas County (3–5 weeks), mid-construction inspections and possible re-dos, tile and glass lead times, hidden conditions behind the walls in older homes (cast iron drains, unpermitted DIY work), and the sheer number of trades involved. A bathroom packs every building system into one small room — plumbing, electrical, waterproofing, ventilation, carpentry, tile, glass, and finish work all have to happen in the right sequence.
Can I speed up a bathroom remodel?
Yes, but only at the front end. Lock tile and fixture selections during pre-construction so nothing stalls once demo starts. Order long-lead items (custom vanity, specialty tile, frameless glass) before the permit is pulled. Run a camera scope of the drain line before demo to catch cast iron issues early. Once construction starts, the timeline is driven by inspections and cure times — and those don’t compress without cutting corners.
How long does a condo bathroom remodel take in downtown St. Pete?
Downtown condo bathroom remodels typically run 6–8 weeks of active construction for a scope that would take 4 weeks in a single-family home. The difference is elevator scheduling, restricted working hours, HOA architectural review on the front end (2–6 weeks), and stricter noise/dust protocols. Revolution has run 30+ high-rise condo projects and plans for these logistics from day one.
Key Takeaways
- Active bathroom construction runs 1 week (cosmetic refresh) to 12+ weeks (custom primary suite). Most mid-scope gut renovations take 3–4 weeks.
- Total calendar time from first meeting to final walkthrough is 2–6 months, including design, selections, pre-construction, and Pinellas County permit review (3–5 weeks).
- Delays come from five sources: permit review, inspection re-dos, tile and glass lead times, hidden conditions in older homes, and logistics in condos or historic districts.
- St. Pete–specific factors: cast iron drain stacks in pre-1975 homes, condo elevator scheduling, historic district COA review, and coastal flood zone rules.
- Revolution’s 20+ in-house W-2 carpenters, dedicated superintendents, open-book T&M pricing, and weekly budget reports keep bathroom remodels on schedule.
