Non-Load-Bearing Wall
$8K–$15K
Simple partition wall removal, minimal utility relocation, drywall repair, paint, flooring transition. Common in 1950s-1960s ranch homes
Load-Bearing Wall + Beam
$15K–$35K

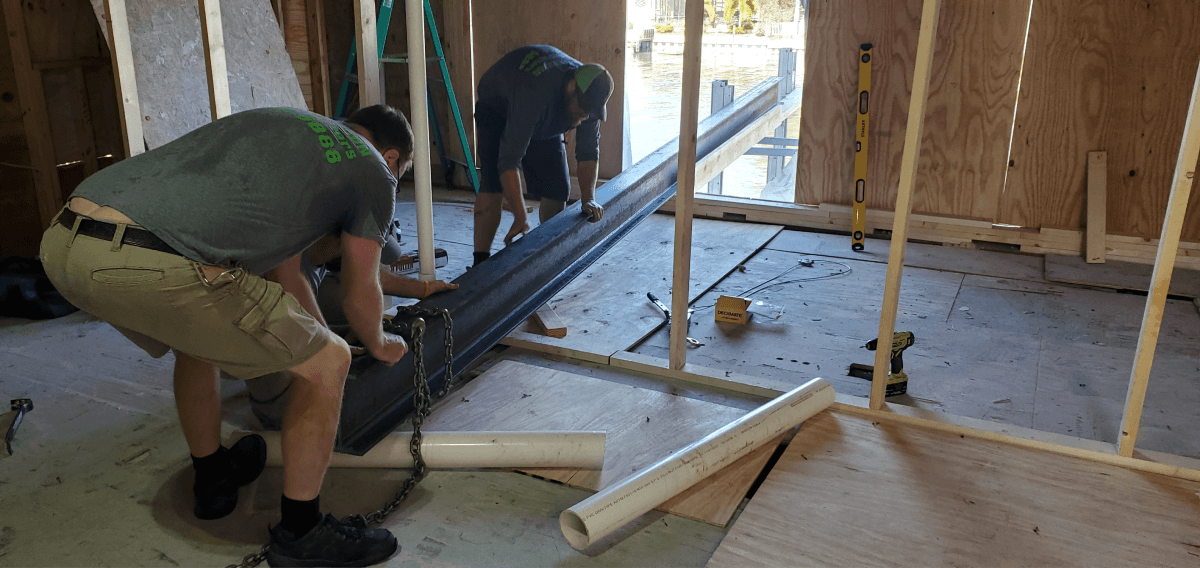

Single load-bearing wall removal with steel beam ($150-$300/LF installed) or LVL beam ($80-$150/LF), structural engineering, permits, utility relocation
Major Structural Changes
$35K–$60K+
Multiple load-bearing walls, complex steel and LVL beam systems with Simpson Strong-Tie connections, second-story framing adjustments, major plumbing relocations
Creating an opening in a load-bearing wall requires structural engineering: Every project starts with a licensed structural engineer who calculates loads, sizes the beam, and provides a stamped letter for permitting. This costs $800-$1,500 and is non-negotiable—St. Pete won't issue a permit without it. Stamped plans typically take three to six months to come back from the architect once you fold in any electrical or plumbing kick-outs and the structural-engineer review cycle.
Total cost stack ranges $30K-$150K+ for most St. Pete projects. A simple non-load-bearing opening with light electrical relocation lands $8K-$15K. A single load-bearing wall with a steel or LVL beam, structural engineering, permit, and finish work runs $15K-$35K. Multi-wall structural changes, second-story framing adjustments, slab cuts to reroute drains, or kitchen-to-living openings that pull HVAC and a load-bearing run together can climb $50K-$150K+ once the scope stacks. The math compounds quickly when an opening turns into a structural cascade.
AE-zone and flood-zone considerations add scope on coastal St. Pete properties. Shore Acres, Riviera Bay, Jungle Terrace, and Lakewood Estates are substantially in Pinellas County's Special Flood Hazard Areas. When a floor-plan opening requires slab penetration to reroute drains — common in CBS block homes — and the total project cost approaches the FEMA 50% Rule threshold (50% of the structure's assessed value), the building department may require bringing mechanical, electrical, and plumbing above base flood elevation as a substantial improvement condition. Revolution coordinates with Pinellas County floodplain administrators and elevation certificate holders to evaluate this during pre-construction — before demolition, not after.
As Jeremy puts it on the math: “If someone just needed raw square footage, we'd be able to design a more simple house—maybe a more rectangular design with a plain hipped roof that we would have seen built here in the mid-century. Versus something with more cuts and hips in the roof and more intentional spaces like butler's pantries or sculleries that begin to drive cost up.” The same logic applies to wall removal: a single straight opening in a 1950s ranch costs a fraction of opening up a 1920s craftsman with stacked second-floor framing and cast-iron drains in the wall.
